Reporting progress against tasks

Before you start to report progress against tasks, you must check that you are using the correct progress period.

Checking that you are using the correct progress period

Click + next to Progress Periods in the project view to view the project's progress periods:

Progress Periods in the project view

Note that the Week 1 progress period has a different icon to the rest of the progress periods in the list. This indicates that it is currently set to the be "progress entry period", ie the one that is currently being used to record progress in the project. This is correct for now; later, you will set other progress periods to be the "progress entry period".

Using the spreadsheet to report progress against a task

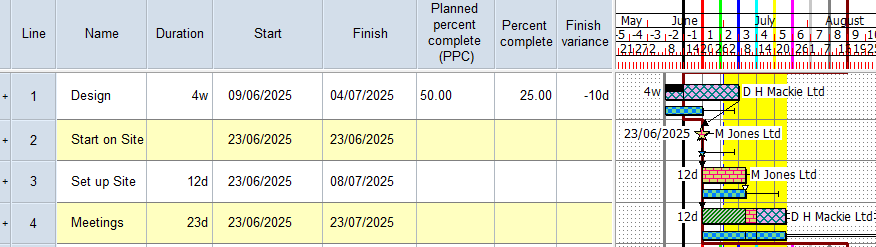

Click in the Percent complete column in the Design row and enter "25" then click away. Black shading - black is the colour of the Week 1 progress period - appears on the first quarter of the Design task. This indicates that the Design task has progressed by 25% in the Week 1 progress period:

Black shading on the first quarter of the Design task

Let us now assume that you have reached the end of the Week 1 progress period. At the end of each progress period, it is good practice to reschedule your project, straightening the progress line of the progress period you have just completed. You will do this now: on the Home tab, in the Schedule group, click Reschedule Branch and click OK to dismiss the Reschedule Progress Period Warning dialog when it appears. The Pre-Construction summary group is rescheduled and the Week 1 progress line is straightened, pushing all uncompleted tasks to the right of it:

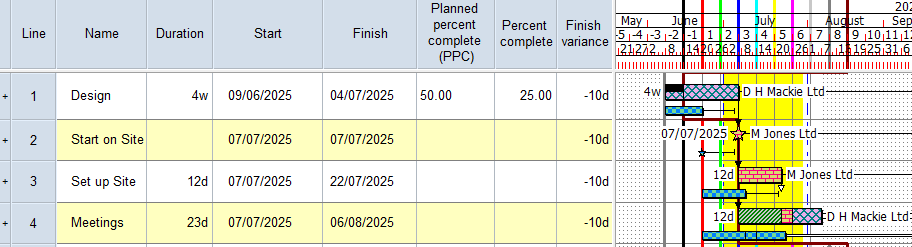

At the end of the Week 1 progress period

Locking progress periods and specifying the progress entry period

When marking progress against tasks and allocations, it is important to ensure that you always use the correct progress period for the current week or month: if you select the wrong progress period when marking progress, tasks will be moved into the wrong position when you perform a reschedule and you will lose your accurate record of when progress on tasks actually took place.

One way in which you can prevent progress from being marked using the incorrect progress period is to lock historical progress periods to prevent their use. You can also, if you wish, lock future progress periods to prevent their use. If you were to do this at the end of each progress period - after you have rescheduled the project - you would always ensure that only the current progress period was available for use.

Another way in which you can prevent the accidental use of the wrong progress period is to specify the progress entry period - one that is used by default each time progress is marked against a task, unless a different period is specified. It makes sense to specify the current progress period as the progress entry period at the same time as you lock old progress periods to prevent their use. Here you will do both.

First of all, examine the progress periods in the project view:

Progress periods in the project view; a red tick appears against Week 1

At the moment, the Week 1 progress period is selected as the progress entry period - a red tick appears against it - and no progress periods are currently locked. You will now set Week 2 as the progress entry period and lock the Week 1 progress period to prevent its accidental use:

  1. Right-click the Week 2 progress period in the project view and select Progress Entry Period from the menu that appears. The red tick moves from the Week 1 progress period to the Week 2 progress period, signifying that it is now the progress entry period:

    The red tick moves from the Week 1 progress period to the Week 2 progress period
  2. Right-click the Week 1 progress period and select Locked from the menu that appears. A padlock symbol appears against the Week 1 progress period, signifying that it is now locked and not available for use:

    A padlock symbol against the Week 1 progress period

Reporting progress against more tasks

  1. Click the uncompleted section of the Design task in the bar chart to select it:

    The uncompleted section of the Design task selected in the bar chart
  2. Click in the Percent progress control at the far left of the Object Edit toolbar and select 100%:

    Selecting 100% in the Percent progress control

    Red shading - red is the colour of the Week 2 progress period - appears on the remaining section of the Design task. This indicates that the Design task has been completed in the Week 2 progress period:

    Red shading on the remaining section of the Design task
  3. Click in the Percent complete column in the Start on Site row. A dropdown progress selector appears. This is because the Start on Site task is a milestone. For milestones, you can only report progress of 0% or 100%, as milestones are either incomplete or complete. Select 100% and click away:

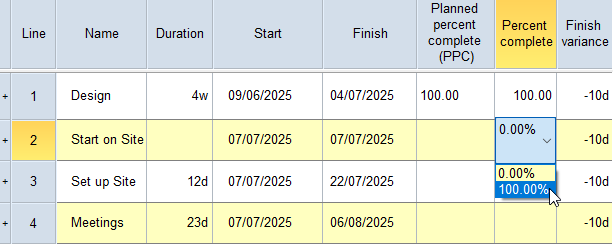

    The dropdown progress selector in the Percent complete column
  4. Let us now assume that you have reached the end of the Week 2 progress period. On the Home tab, in the Schedule group, click Reschedule Branch and click OK to dismiss the Reschedule Progress Period Warning dialog when it appears. The Pre-Construction summary group is rescheduled and the Week 2 progress line is straightened, pushing all uncompleted tasks to the right of it:

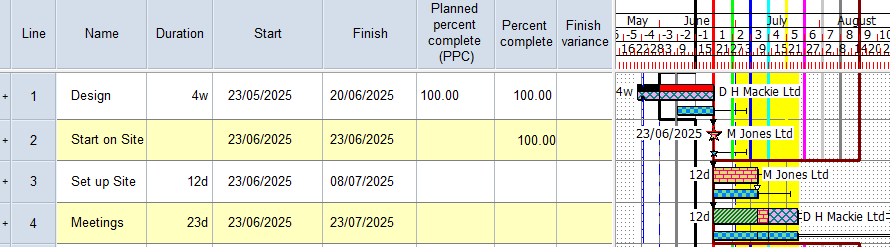

    At the end of the Week 2 progress period
  5. Right-click the Week 3 progress period in the project view and select Progress Entry Period from the menu that appears. The red tick moves from the Week 2 progress period to the Week 3 progress period, signifying that it is now the progress entry period.
  6. Right-click the Week 2 progress period and select Locked from the menu that appears. A padlock symbol appears against the Week 2 progress period, signifying that it is now locked and not available for use.

Your project should now look something like this (note that the dates and durations of tasks, and the appearance of codes, annotations, resources, cost centres and baseline tasks, may be different):

Illustration of the project at this stage

Previous Next
Configuring a table for progress reporting

Merging data into a baseline
